Most people asking what a wave pool costs mean the price of a session, and we answer that in a separate price guide. This is the other question: what does it cost to build one? That number is far bigger, far less public, and it explains almost everything about why some parks open and so many never do.
The short version is that a commercial wave pool is a construction megaproject with a surf machine sitting inside it, and the machine is one of the smaller line items.
The short answer
A standalone commercial wave pool with the basic buildings around it starts near 30 million US dollars. Add a hotel and hospitality and you are closer to 100 million. Wrap it in a master-planned real estate community, which is how most large parks now get financed, and the total runs well past 100 million, with Atlantic Park in Virginia Beach reported as a 350 million dollar mixed-use development. Wavegarden's own estimate for a standard park in Spain puts the lagoon, water treatment and wave generator together at 10 to 25 million euros, out of a total development cost of 25 to 40 million.
Where the money actually goes
A surf park budget breaks into a handful of buckets, and the wave is rarely the largest.
- Land. Wavegarden's standard Cove takes a footprint of about 20,000 square meters, roughly 5 acres, before parking, buildings and landscaping; The Point in Florida sits on a 10.5-acre site. In a market worth building in, the land is often the single most expensive item before anything is poured.
- The lagoon. Excavating, shaping, and lining a multi-acre basin, then engineering the contoured floor that actually forms the wave, is heavy civil construction. This is where the schedule risk lives, and where reclaimed or difficult sites blow past their budgets.
- The wave system. The machine that generates the swell: paddles, pneumatic chambers, a hydrofoil, or a plunger, depending on the technology. We break down how each one works in the technology comparison.
- Water treatment. A pool holding millions of gallons needs filtration, circulation, and sanitation running continuously. It is a real slice of both the build and the operating cost.
- Buildings and grounds. The surf academy, food and beverage, retail, changing rooms, decks, and everything a paying visitor touches.
- Soft costs. Design, engineering, permitting, financing, and contingency, which on a project this complex is not optional.
The machine is the cheaper part
This surprises people. The wave technology is often the line item they assume dominates the budget, and it usually does not.
A standing-wave system, the kind that produces a stationary wave you ride in place, is a far smaller build, though its makers do not publish prices. For a full traveling-wave lagoon, Wavegarden publishes estimates for a standard park in Spain: 25 to 40 million euros in total development cost, of which 10 to 25 million covers the lagoon, the wave generator and the water treatment system together. It notes the figures move with lagoon size, how difficult the civil works are, the country, and the wave generator chosen.
In other words, the thing that makes the wave is bundled into a package where dirt, concrete, and buildings carry most of the weight. A developer cannot make a project cheap by choosing a cheaper wave. The savings, if there are any, come from the land and the civil work.
What each wave system costs
Cost questions usually arrive attached to a vendor rather than in the abstract, so here is what is actually public per system. These are the figures the companies or their developers have put on the record; where nothing is public, that is said plainly rather than filled in.
Wavegarden is the only vendor publishing a number: 25 to 40 million euros in total development cost for a standard park in Spain, 10 to 25 million of it for the lagoon, water treatment and wave generator. With 12 open Wavegarden parks in our directory, it is also the most benchmarked system in the industry.
Endless Surf does not publish pricing. Its systems are sized by caisson count, which is the closest thing to a cost proxy: an ES36 like The Point is a smaller build than the 48-chamber basin Meriwether describes for Thermal Beach Club. The Point has been reported as a 30 million dollar project.
PerfectSwell from American Wave Machines does not publish pricing either. Its installations range from Waco Surf to the 220-metre pools in Brazil, so the spread is wide and no single figure would be meaningful.
Kelly Slater Wave Co is the outlier at both ends. The original Surf Ranch was reportedly developed for around 30 million dollars, a figure Stab attributed to a CNN documentary in 2018, and the system's economics are different from every other vendor's: one foil produces one wave at a time, so the same capital buys far fewer rides per hour.
Standing waves are the cheap entry point. Citywave and UNIT do not publish prices, but a standing wave needs no multi-acre lagoon, which is why they keep appearing inside entertainment complexes and water parks rather than as standalone destinations.
UNIT Surf Pool cost is the question we get most for a single system, and UNIT still does not put a number on its website. What it does publish explains why it is the cheapest route to a surfable wave: the pool floats on an existing lake or lagoon, so there is no excavation or groundwork, it is built from standardized modular steel, UNIT quotes a two-week installation, and the pumps, control panel and electrical cabinets are included in the purchase price. It takes up to 12 surfers per session. The saving is in the civil work, which is where most of a lagoon's budget goes.
Backyard wave pools are not a product any of these vendors sells to single homes, and none publishes a residential price. The private waves in our directory are shared amenities inside residential communities: Southern Shores in Hurricane, Utah, runs a 16-metre UNIT wave for its residents, where lakeside lots were priced up to 2.5 million dollars in 2023, and Three Bridges and Zion Shores follow the same model. If you want your own wave, buying into one of these communities is the realistic version, and our guide to buying a home at a surf park covers them.
The pattern across all of them: the wave is a minority of the budget, and no vendor choice makes a project cheap. Land and civil work decide that.
Real numbers from real parks
Public build costs are rare because most developers never publish them, but a few anchors exist.
- The Kelly Slater Surf Ranch in Lemoore was reportedly developed for around 30 million dollars, which for years set the mental benchmark for a serious wave.
- Lost Shore in Scotland was built for a reported 60 million pounds, roughly 80 million dollars, including its resort elements.
- The Point in Florida, the first Endless Surf lagoon in the US, has been reported as a 30 million dollar project.
- The large mixed-use developments, the ones pairing a lagoon with hotels and hundreds of homes, are where figures climb into the hundreds of millions.
Read those as order-of-magnitude markers, not quotes. Every site is different, and a desert build, a reclaimed quarry, and a flat greenfield lot do not cost the same thing.
What it costs to run
Building the pool is only half the problem. Running one is a serious ongoing expense, and energy is the variable that separates the technologies.
Moving that much water takes a lot of power, and vendors claim the efficiency gap between systems is large. The most-quoted figures come from Wavegarden's own energy study, which puts a Cove at 250 to 450 kilowatt-hours per hour of operation, says a pneumatic system needs roughly ten times as much, and estimates the saving at 1.3 to 2.7 million dollars a year for a busy park delivering one to two million waves, at an electricity price of 15 cents per kilowatt-hour.
Those numbers get repeated everywhere, including in earlier versions of this guide, usually without the label they deserve: this is a manufacturer comparing its own product against a competing technology, not an independent benchmark. The electricity price alone changes the headline saving substantially, so treat it as a vendor estimate rather than a neutral test.
What is not in dispute is that power is a major operating line, and that some operators chase it directly: The Wave in Bristol runs on an on-site solar array that it says produces more electricity over a year than the park consumes.
On top of power, an operator is paying continuously for water and its treatment, for staffing across coaching, lifeguarding, and hospitality, and for maintenance on a machine that runs thousands of cycles a day. None of it stops when the surfers go home.
How to build a surf park, step by step
Every project in our directory has gone through the same five stages, and the timelines below come from parks we track rather than from a brochure.
1. Find a site. Wavegarden's published requirements for a standard Cove are a plot of about 160 by 160 metres, a 20,000 square metre footprint, or about 100 by 100 metres (8,000 square metres) without the beginner areas. Add parking, buildings and hospitality and most parks sit on 10 acres or more; Shell Point in Panama City Beach is planned on 10.5 acres, and Jacksonville Surf Park on a 45-acre site.
2. Get approvals. This is usually the longest stage. Surf London won local planning approval in September 2025 and needed a further sign-off from the Greater London Authority before permission was granted in early 2026. Peak Surf Park near Tampa won its county rezoning in September 2026 with more permitting still ahead, and South Britannia in British Columbia spent years in rezoning before approval.
3. Fund it. Approval does not mean money. After its planning permission, Surf London was still completing fundraising and its lease; Perth Surf Park only broke ground once its institutional funding was secured. This is the stage where most stalled projects stall.
4. Build it. Once ground breaks, a lagoon park typically takes around 18 months to two years. Perth Surf Park began construction in April 2026 for first waves in spring 2027, and Palm Valley on the Gold Coast describes a two-year build. A floating UNIT standing wave is the exception at about two weeks to install, because the lake already exists.
5. Commission the waves. The wave system is tuned on site before opening. At El Nido in Uruguay, the developer said Wavegarden's team would spend 15 to 20 days programming and testing once construction was done.
Why so many announced parks never open
Once you see the real numbers, the industry's biggest pattern makes sense. For every wave pool that opens, several are announced with confident dates and then stall. The wave technology almost never fails them. Financing, land, and construction do.
That is also why the business model has shifted. Very few operators now build a wave pool as a standalone attraction, because the economics are hard on session revenue alone. Instead the pool is the amenity at the center of a real estate development, and the homes, hotels, and memberships are what actually pay for it. We track that model across the pipeline, from surf communities you can buy into to the full opening tracker, and it is the reason a growing share of new parks are private or residential rather than open to the public.
The bottom line
A wave pool is a land deal, a civil-engineering project, and a hospitality business, and the wave itself is one of the smaller checks written along the way. Budget somewhere from 30 million dollars for a lean standalone lagoon to well over 100 million for a resort, and understand that the reason your local project keeps slipping its opening date is almost always everything around the technology.
If you were after the price of actually surfing one, that is our wave pool session price guide. For live market data across every park, see the industry tracker and the full directory.

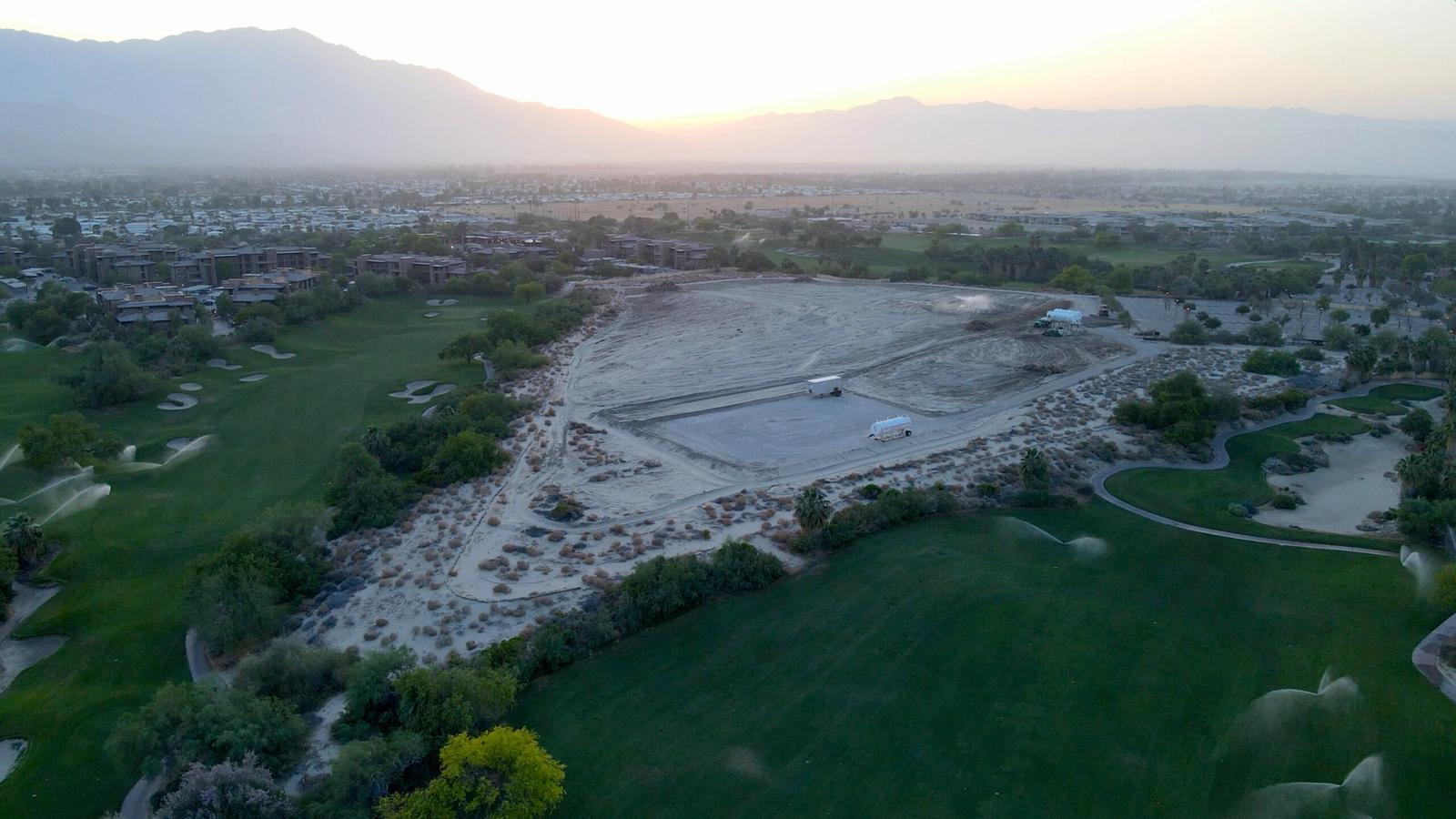

Photo of the DSRT Surf lagoon under construction courtesy of DSRT Surf / Wavegarden.
